Victoria House | Development Progress
Here you will find the latest progress reports and images for the construction of Victoria House in Leeds, UK. Victoria House apartments are fully managed by Morgan City Living and offers a range of studios, 1 bedroom and 2 bedrooms. These come with the option of high quality contemporary furniture packs, including integrated kitchen with high spec appliances, bedrooms are also fully furnished. Communal areas include concierge service, lounge, mounted TVs, parcel storage, full Wi-Fi and much more.
Victoria House comes as a hassle free investment benefiting from an 8% NET yield for 3 years. There is an option for immediate income generation as investors can also opt in to have 4% interest paid on any monies deposited until completion, depending on the payment plan chosen. These apartments are located close to Leeds city centre with on-site parking and communal facilities. Prices start from just £75,000 with 4% paid of deposited funds and NET 8% rental yield assured for 3 years.

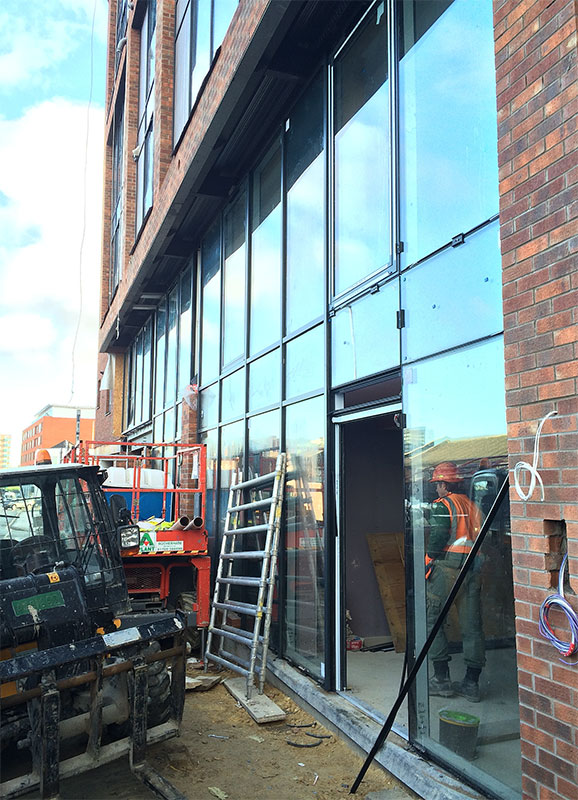

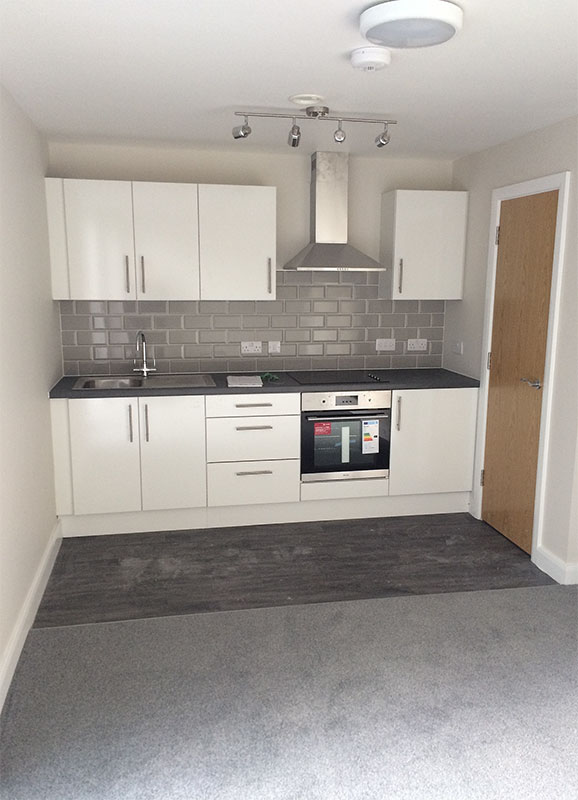

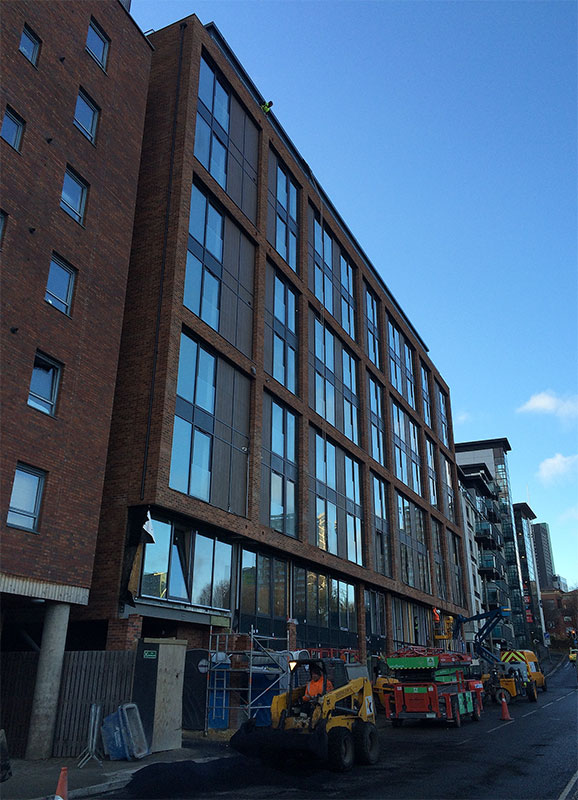

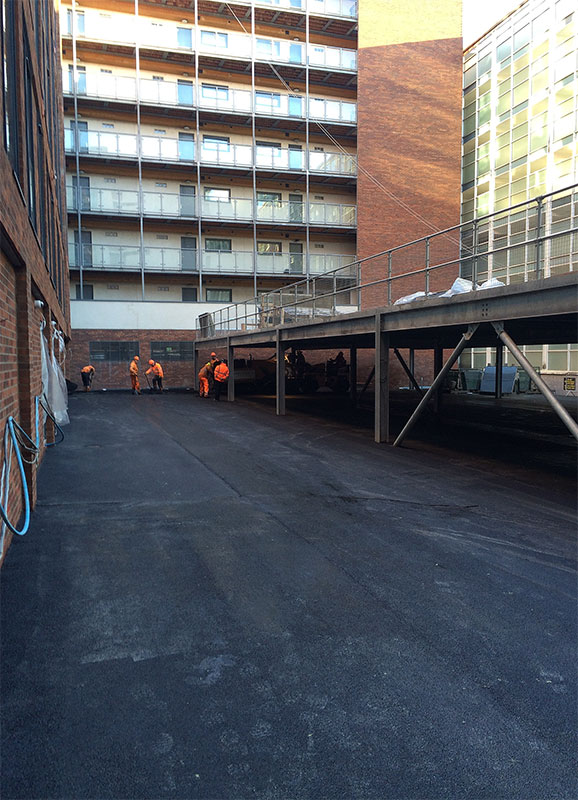

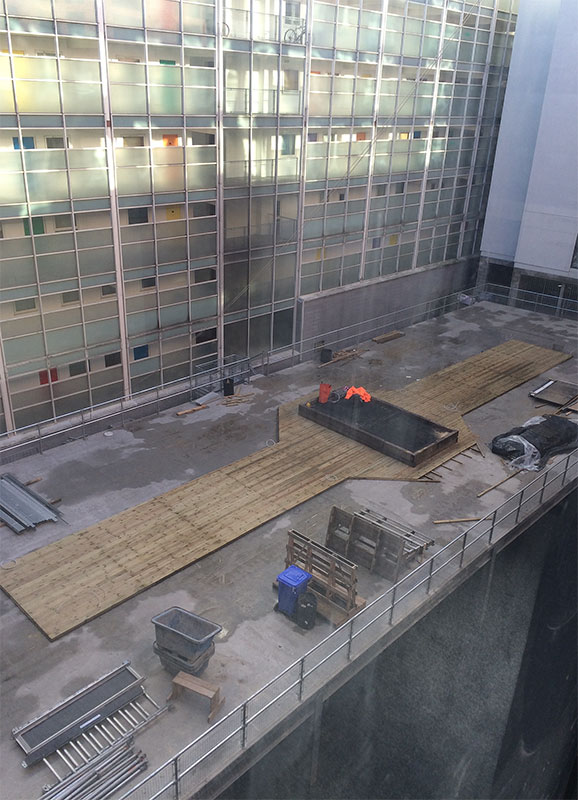

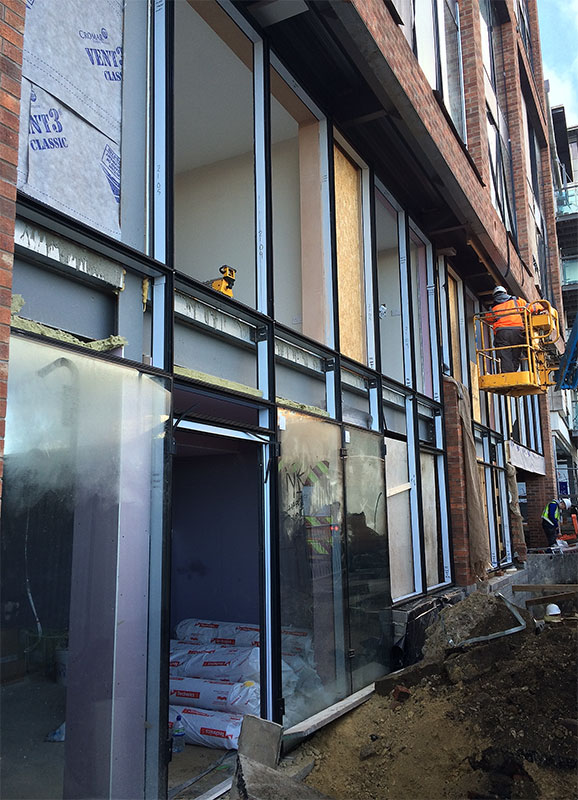

Victoria House | Development Progress 05/12/2017

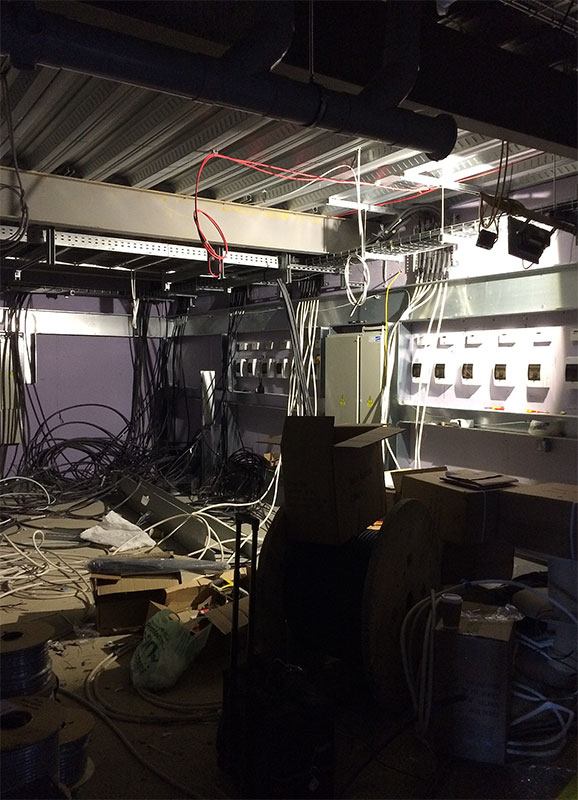

This recent update about the development progress of Victoria House in Leeds is dated from 05/12/2017. Further to the last update and due to issues experienced in obtaining a ‘live’ electricity supply to the building, WYG have reviewed the status of the works with Trilandium and are now targeting. Practical Completion on 19 December 2017.
The attached report goes into more detail about what works have been completed and how things are progressing. Important points are below.
Main Points:
- External walls (brickwork) 100% complete.
- Internal walls (apartments), 100% complete. Wall finishing 95% complete.
- WYG are continuing defects inspections and agreed a timetable up to completion of the project.

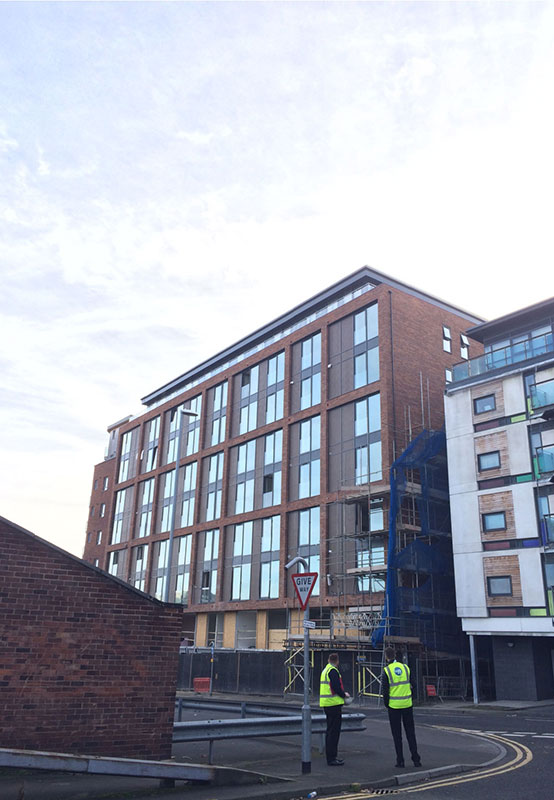

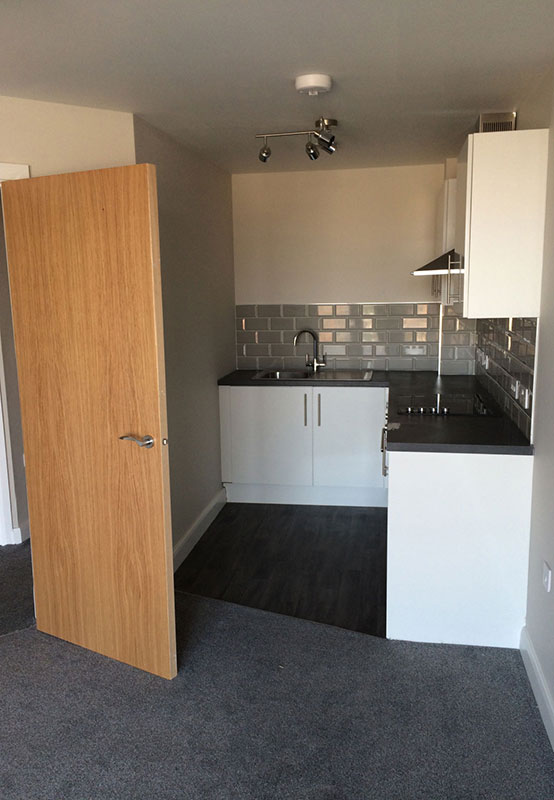

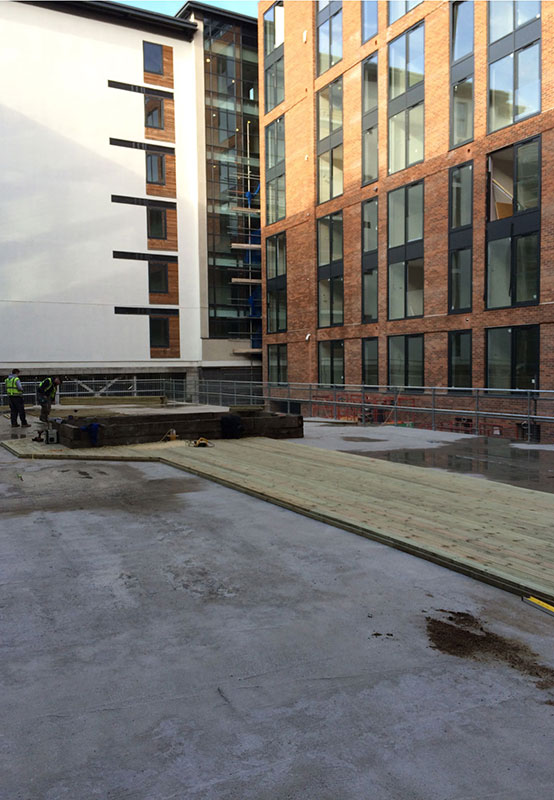

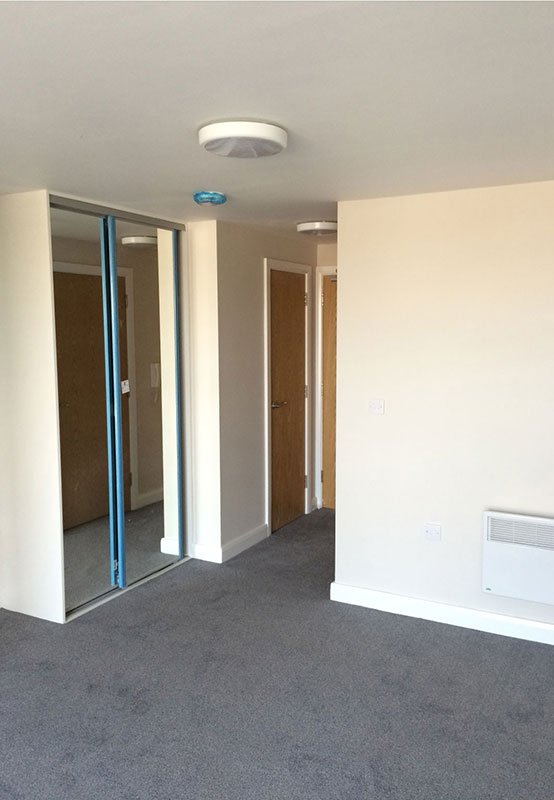

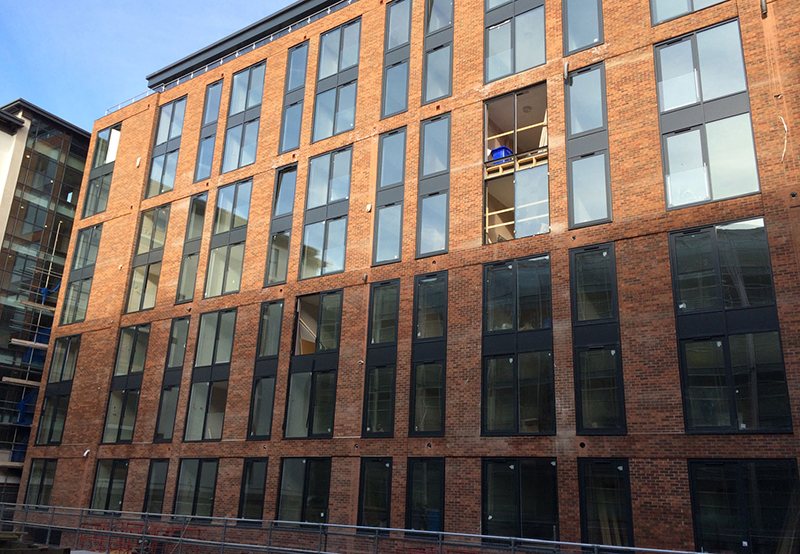

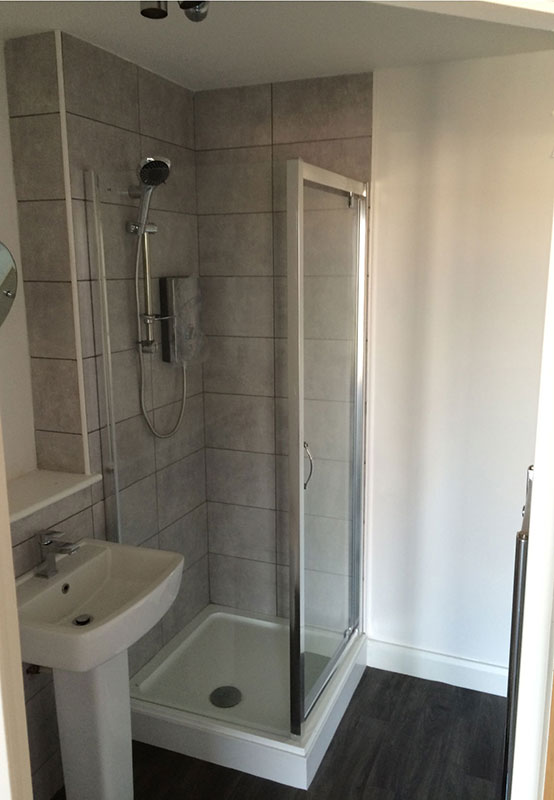

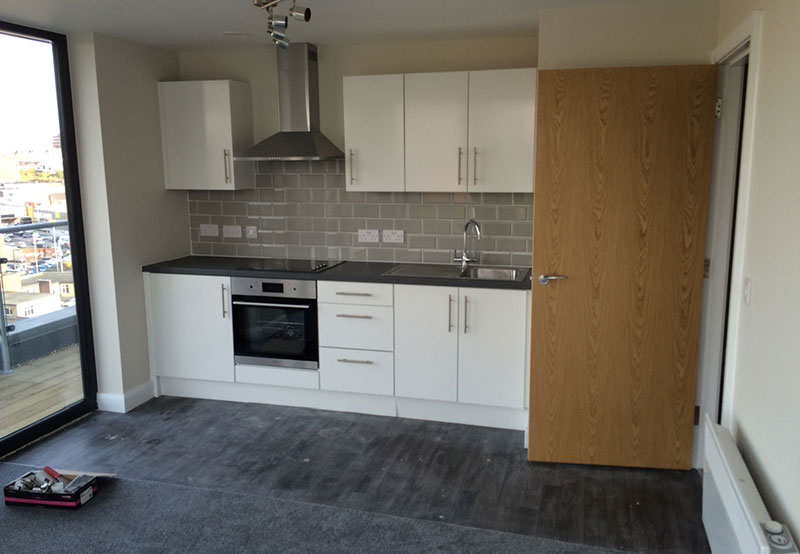

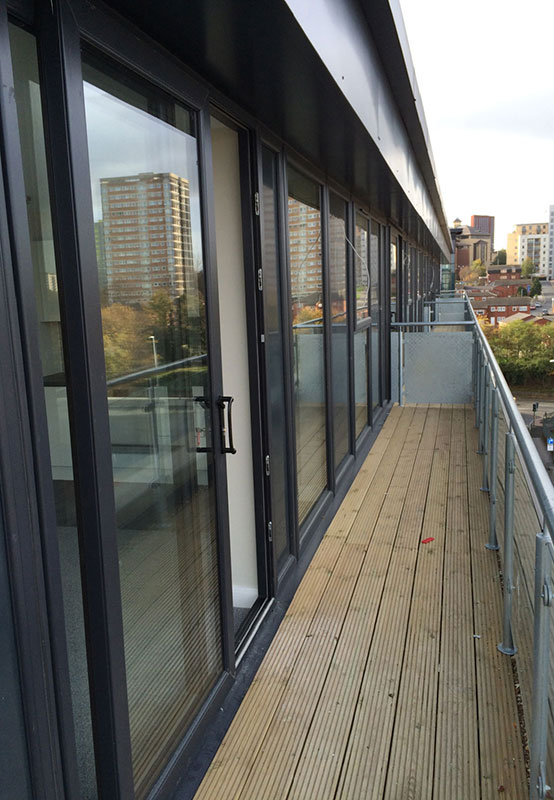

Victoria House | Development Progress 10/11/2017
This recent update about the development progress of Victoria House in Leeds is dated from 10/11/2017. Further to a commercial review meeting with Trilandium 29 August 2017, they have now confirmed that the works are due to be completed on 11 December 2017.
The attached report goes into more detail about what works have been completed and how things are progressing. Important points are below.
Main Points:
- Ceiling finishes, approx 99% complete. Level 1 ongoing.
- Kitchen Installation & Bathroom Tiling, installed Level 1 to 8.
- Electrical Installation to go ‘live’ 11/12 November 2017.

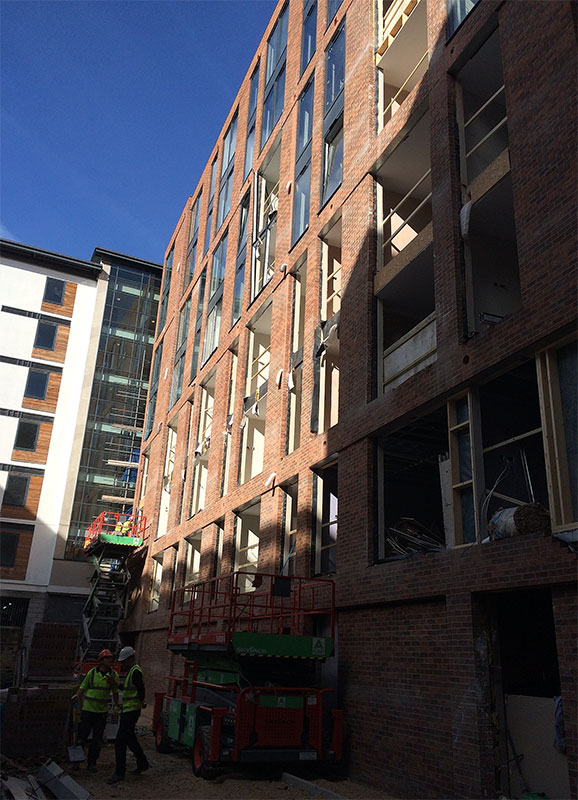

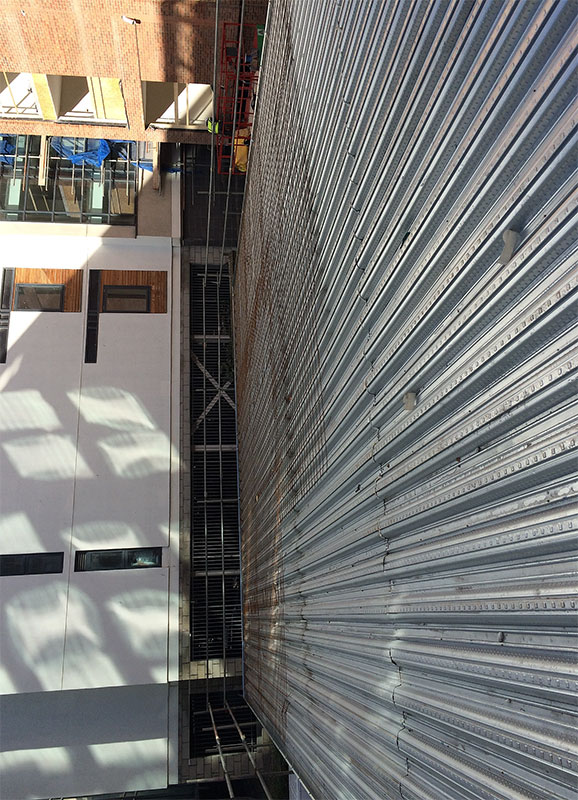

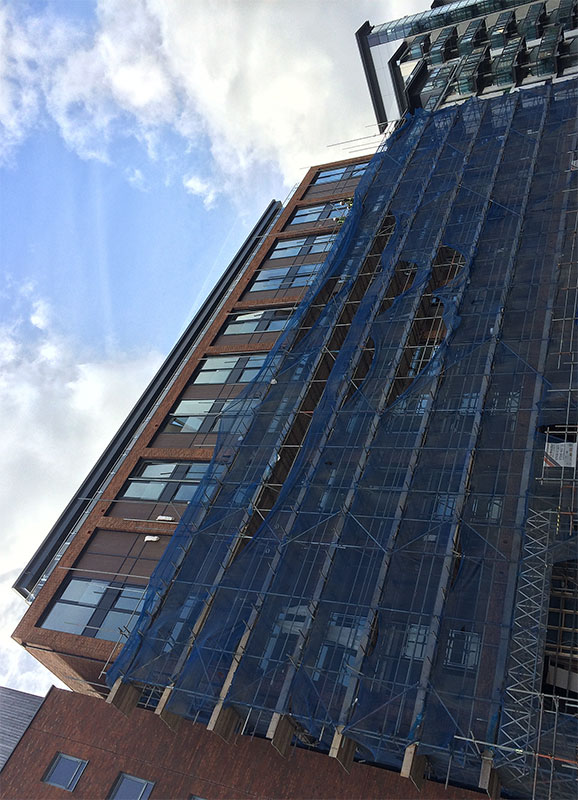

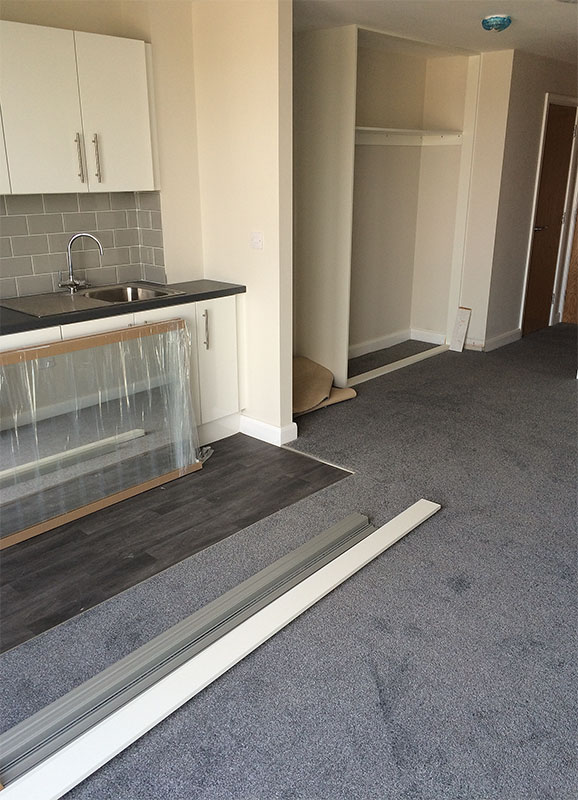

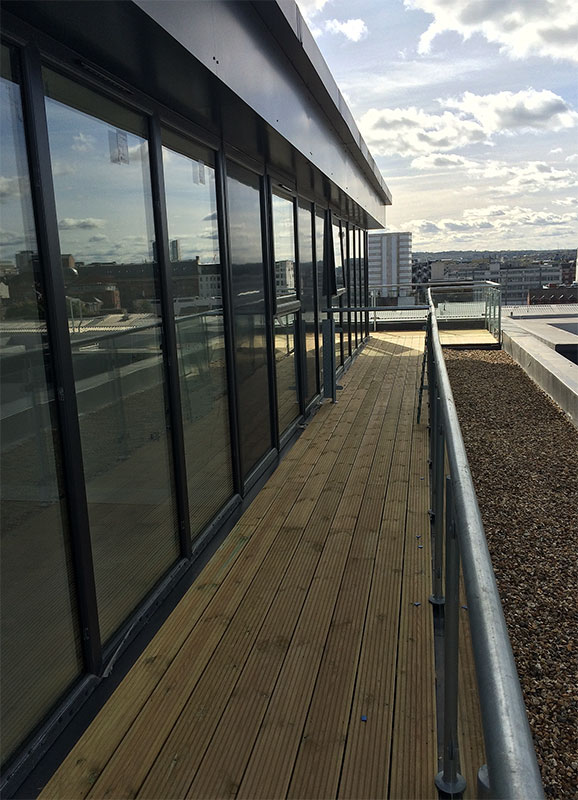

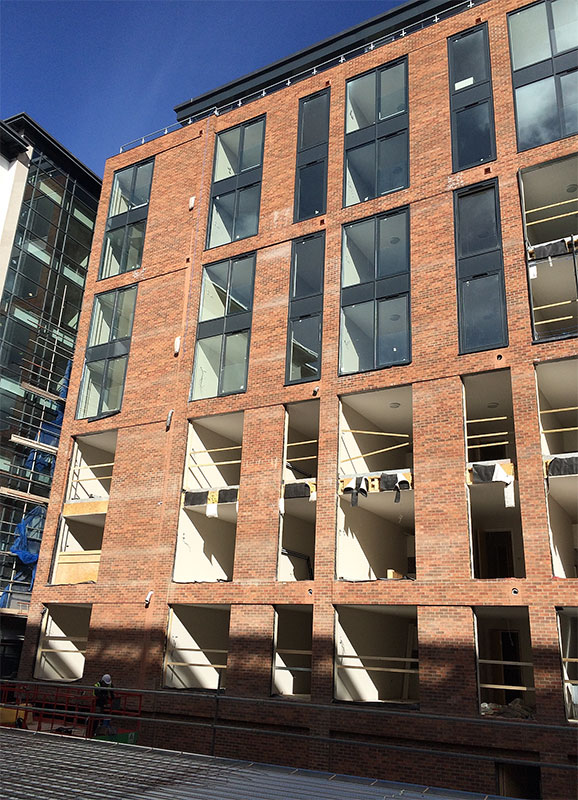

Victoria House | Development Progress 12/10/2017
This recent update about the development progress of Victoria House in Leeds is dated from 12/10/2017. WYG and Trilandium are to agree a variation for conversion of the 2Nr ground floor office units in to 6Nr office units. This involves additional sub-division and M&E works.
The attached report goes into more detail about what works have been completed and how things are progressing. Important points are below.
Main Points:
- Reduced level excavations, piling works, concrete ground beams and foundations, block and beam ground floor, including screeding 100% complete.
- Steelwork frame erection (Main Building), metal decking, edge formwork, concrete to upper floors, pre-cast concrete staircase and lift shaft, 100% complete.
- Below ground drainage, approximately 90% complete.

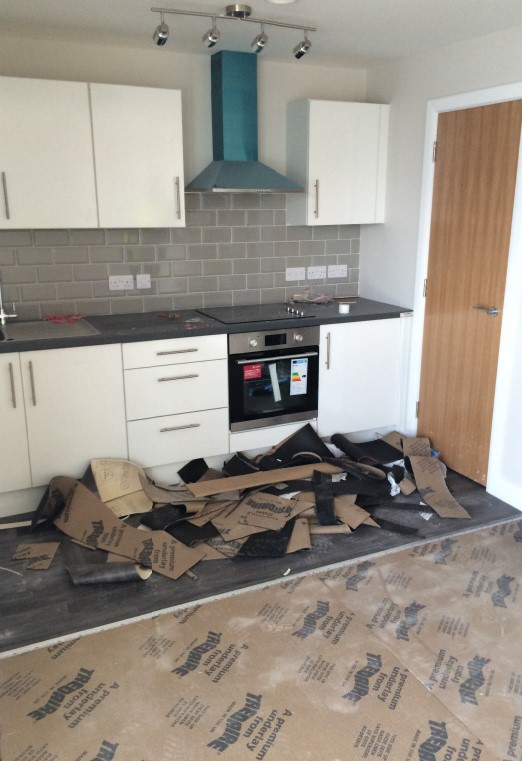

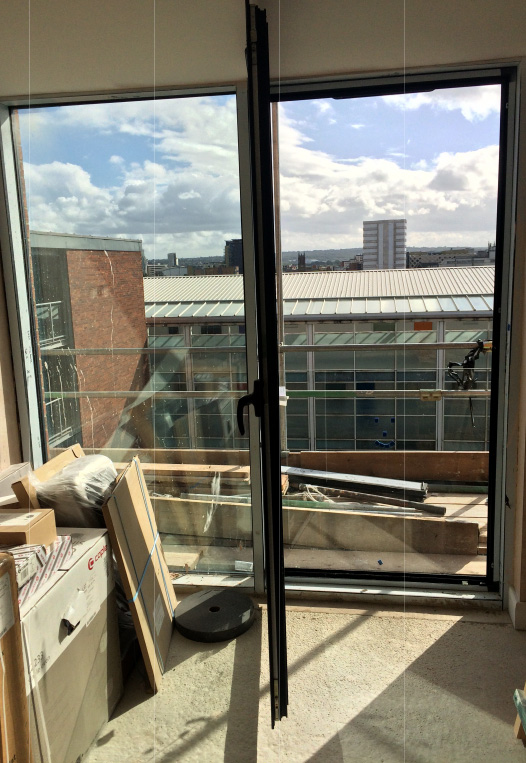

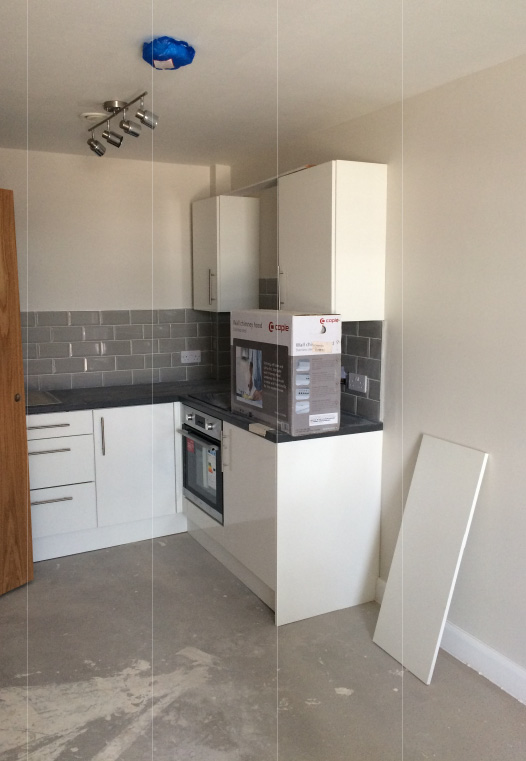

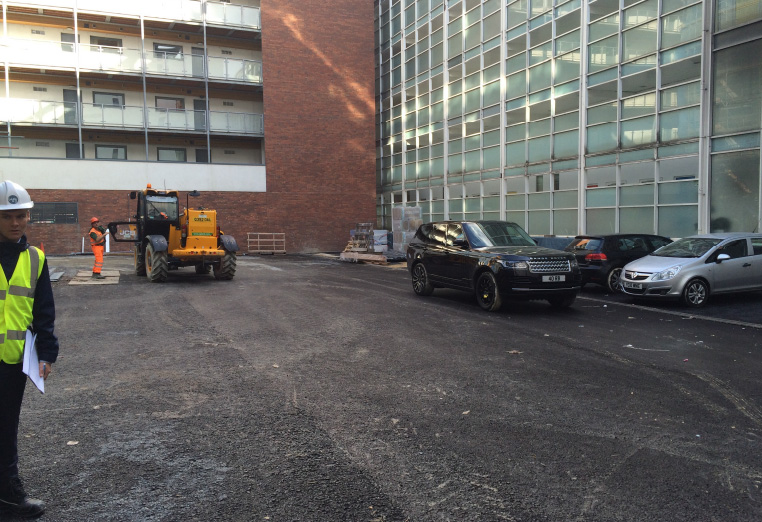

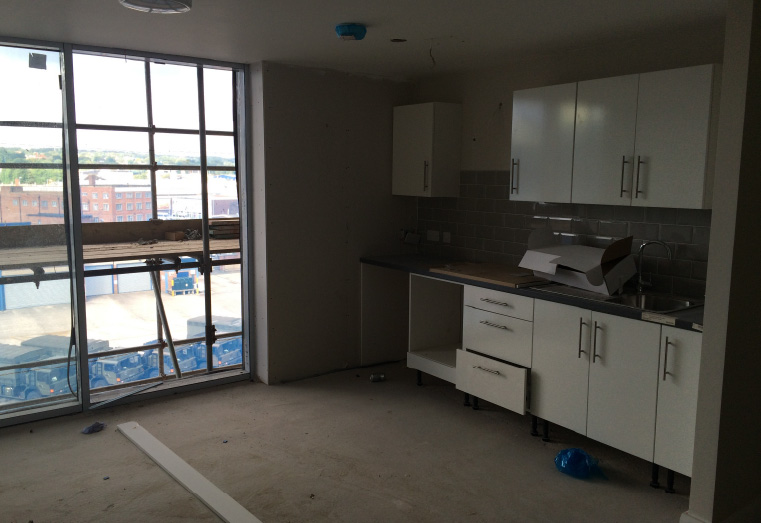

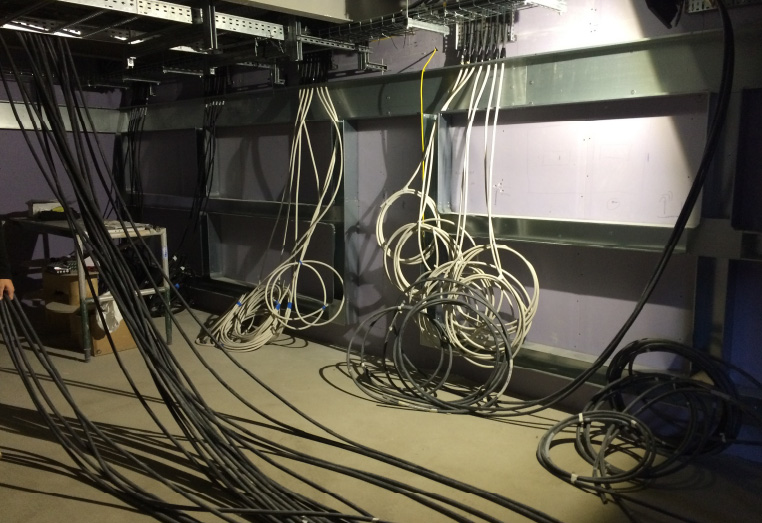

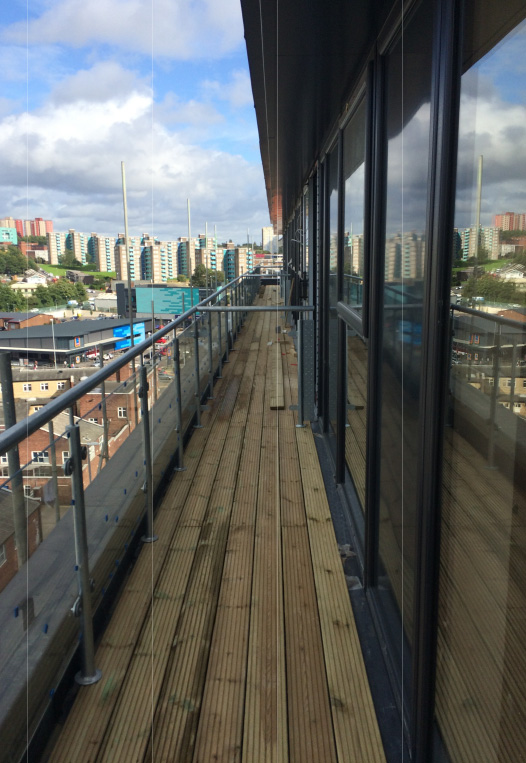

Victoria House | Development Progress 11/09/2017
This recent update about the development progress of Victoria House in Leeds is dated from 11/09/2017. Further to a commercial review meeting with Trilandium on 29 August 2017, they have now confirmed that the works are due to be completed on 11 December 2017.
The attached report goes into more detail about what works have been completed and how things are progressing as well as reason for delays. Important points are below.
Main Points:
- Internal walls (party walls), approximately 100% complete.
- Internal walls (apartments), approximately 98% complete. Skimmed from Level 2 to 8, reveals being completed.
- Ceiling finishes, approximately 95% complete.

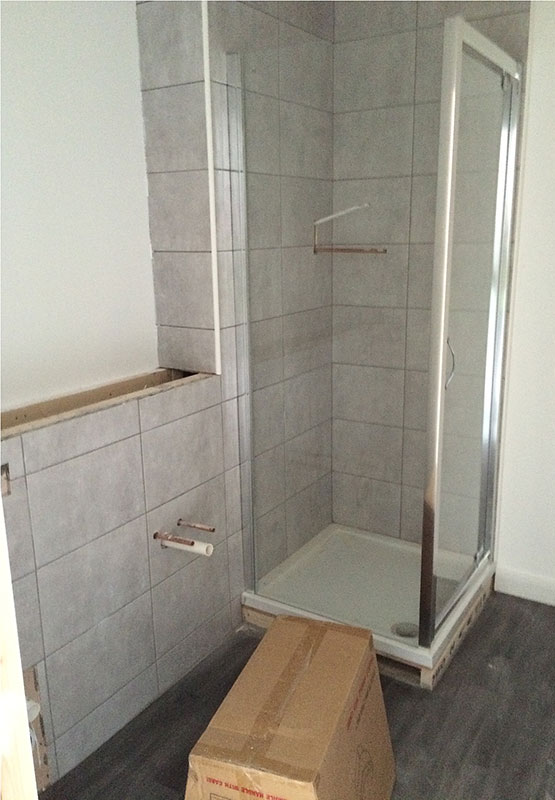

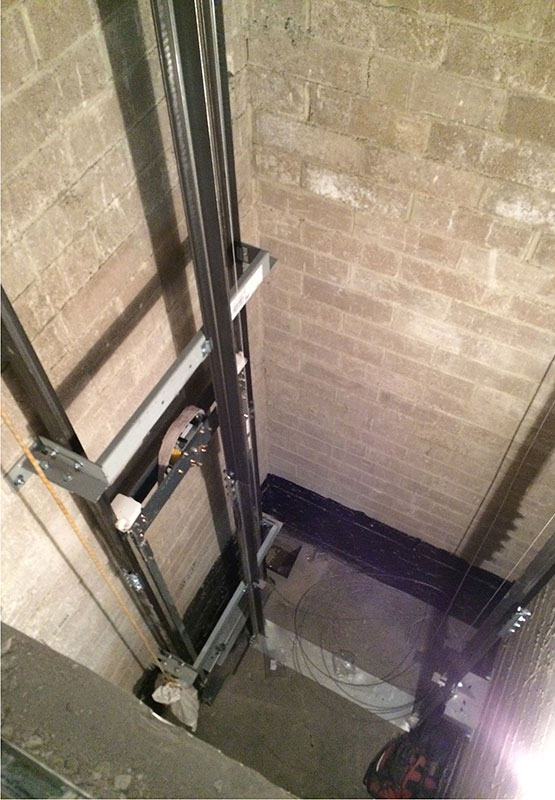

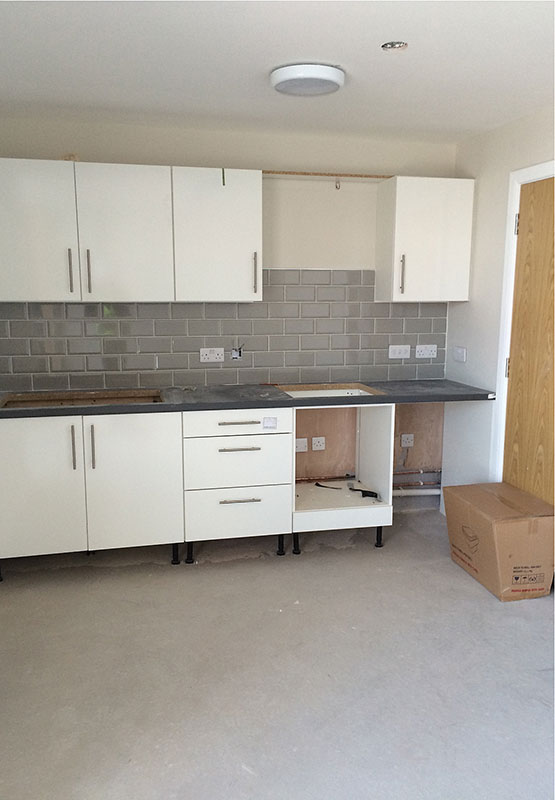

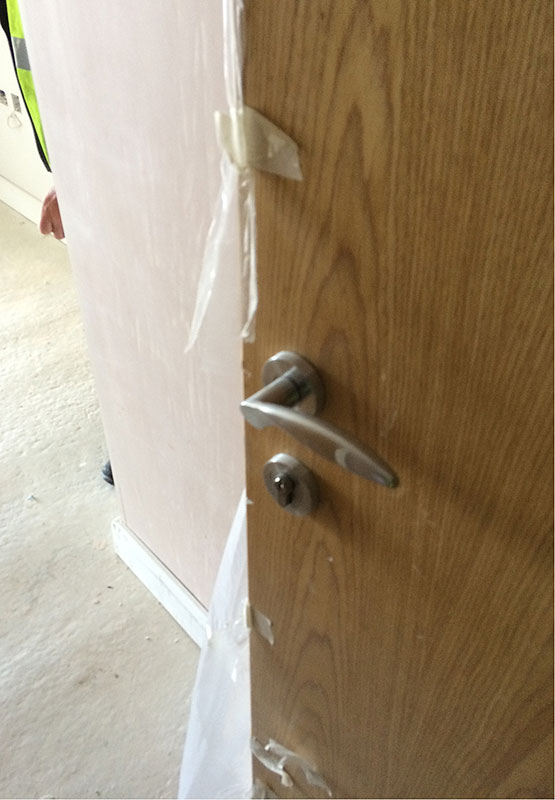

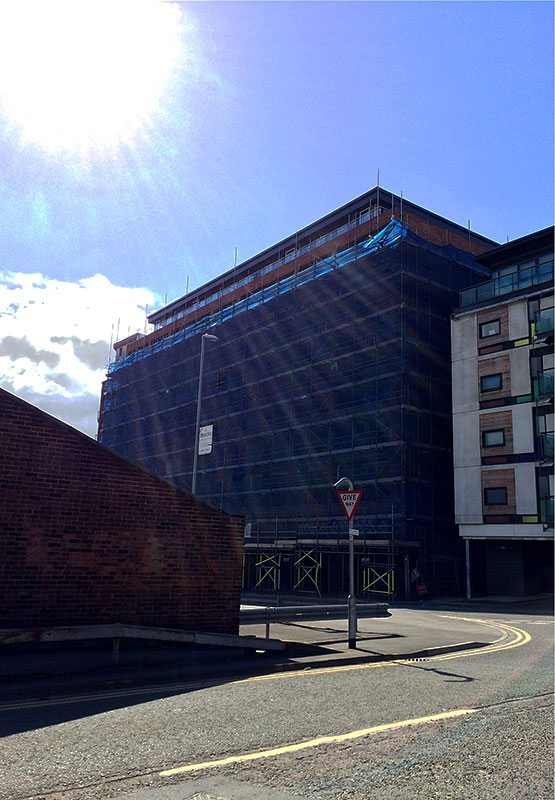

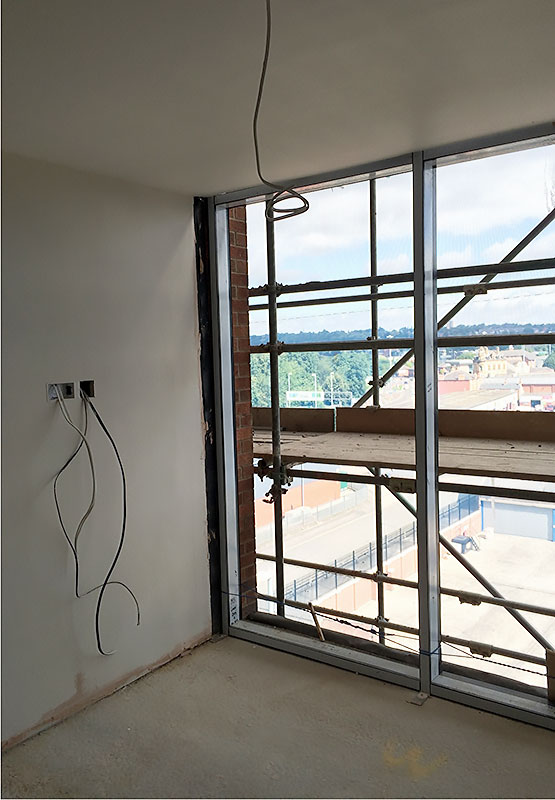

Victoria House | Development Progress 04/08/2017

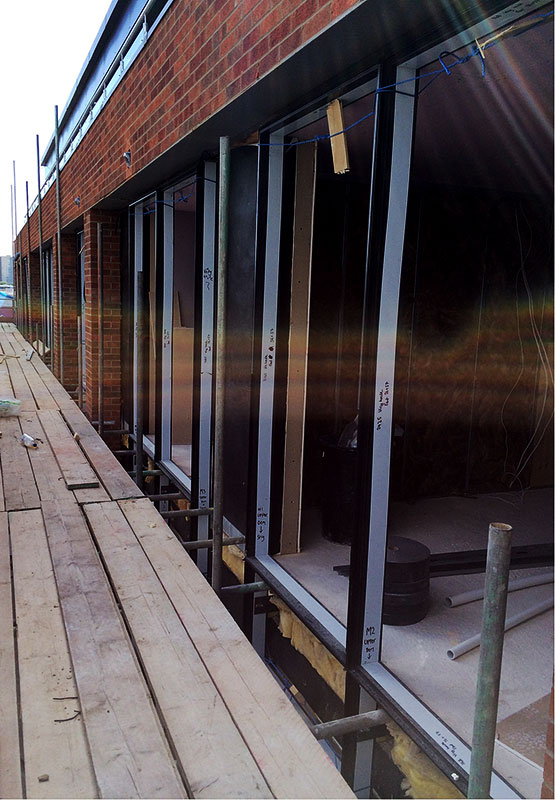

This recent update about the development progress of Victoria House in Leeds is dated from 04/08/2017. Trilandium noted that they experienced delays with the steelwork frame during the January and February period, which has delayed the works by approximately 4 weeks, therefore completion would be approximately 6 November 2017, however they have stated that they will endeavour to complete the works by 9 October 2017.
The attached report goes into more detail about what works have been completed and how things are progressing. Important points are below.
Main Points:
- Internal walls (party walls), approx 95% complete.
- Internal walls (apartments), approx 85% complete. Skimmed from Level 2 to 6, commence to Level 7.
- Ceiling finishes, approx 85% complete.

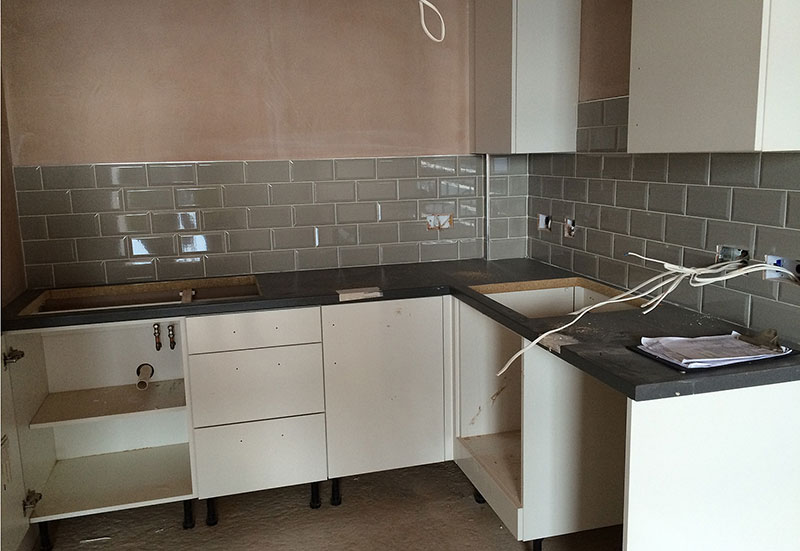

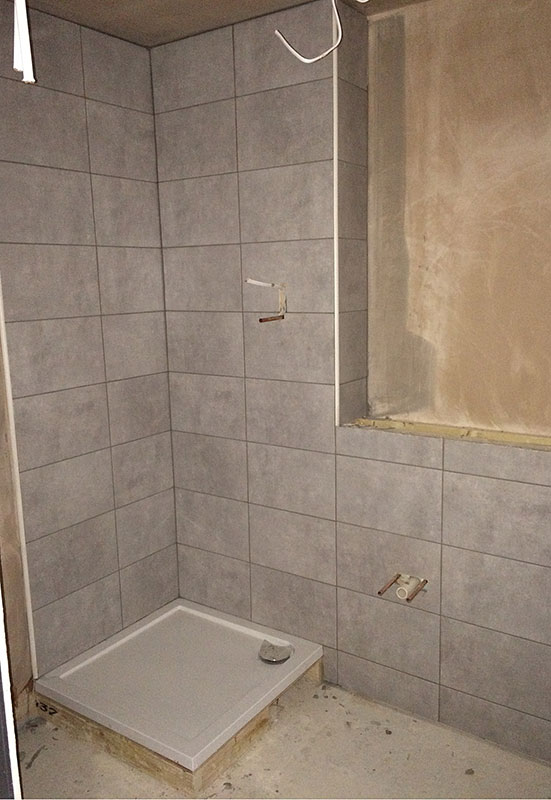

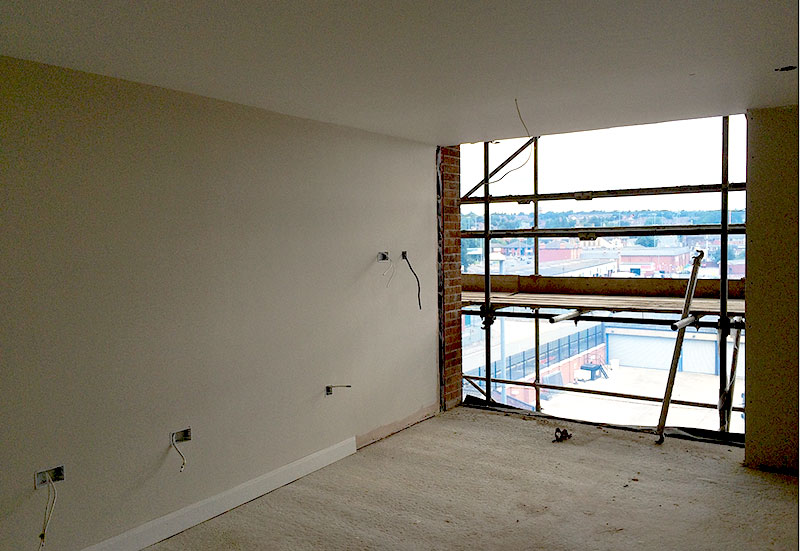

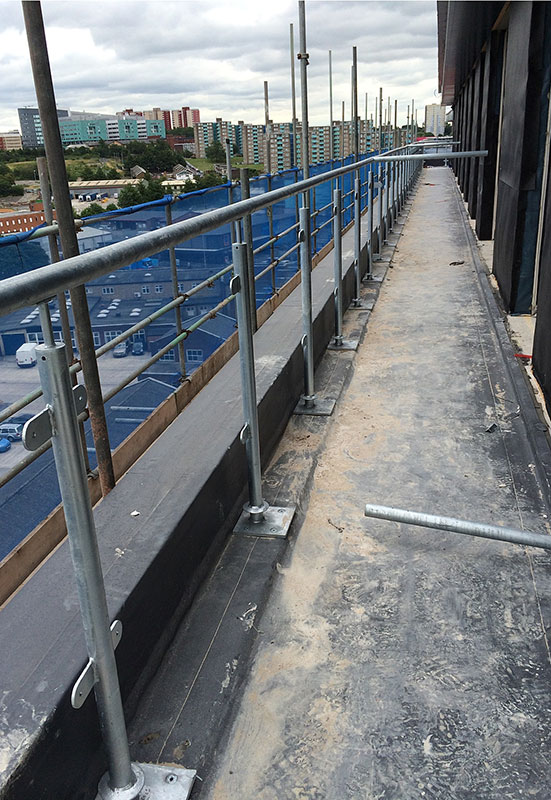

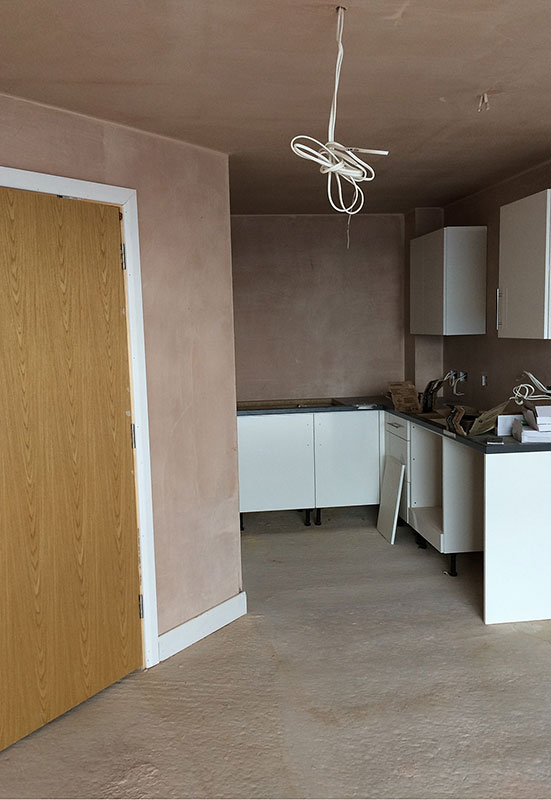

Victoria House | Development Progress 12/07/2017

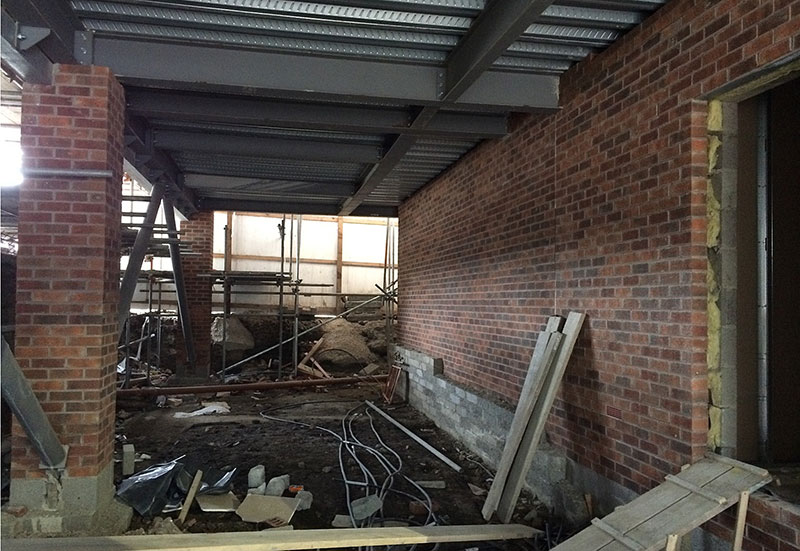

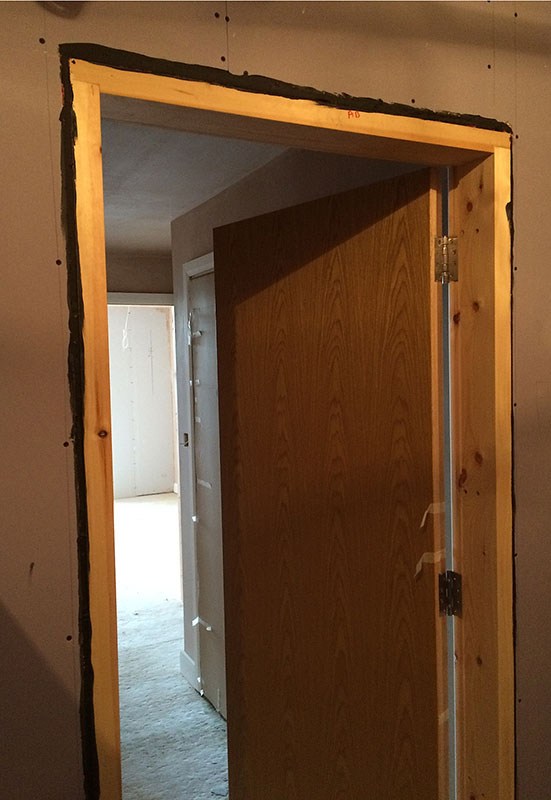

This recent update about the development progress of Victoria House in Leeds is dated from 12/07/2017. Reduced level excavations, piling works, concrete ground beams and foundations, block and beam ground floor, including screeding 100% complete.
The attached report goes into more detail about what works have been completed and how things are progressing. Important points are below.
Main Points:
- External walls (brickwork) approx 99% complete.
- Internal walls (party walls), approx 85% complete.
- Internal walls (apartments), approx 65% complete. Skimmed from Level 2 to 6.

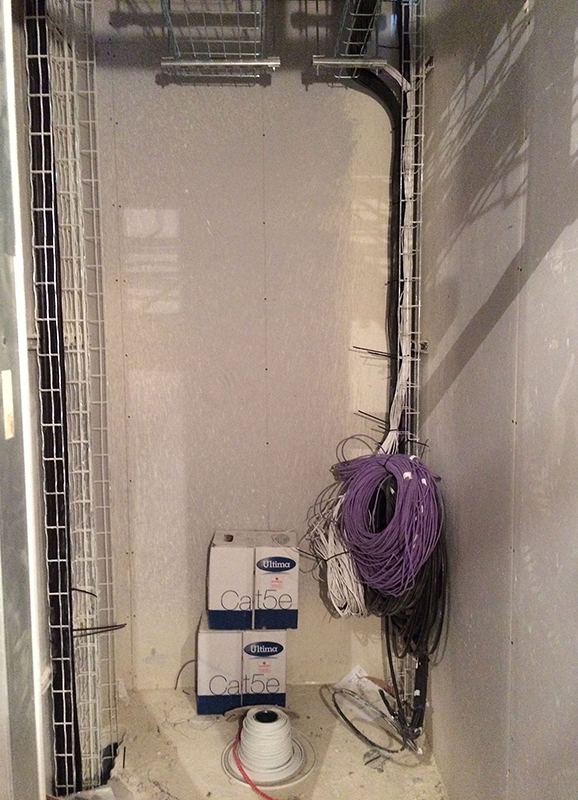

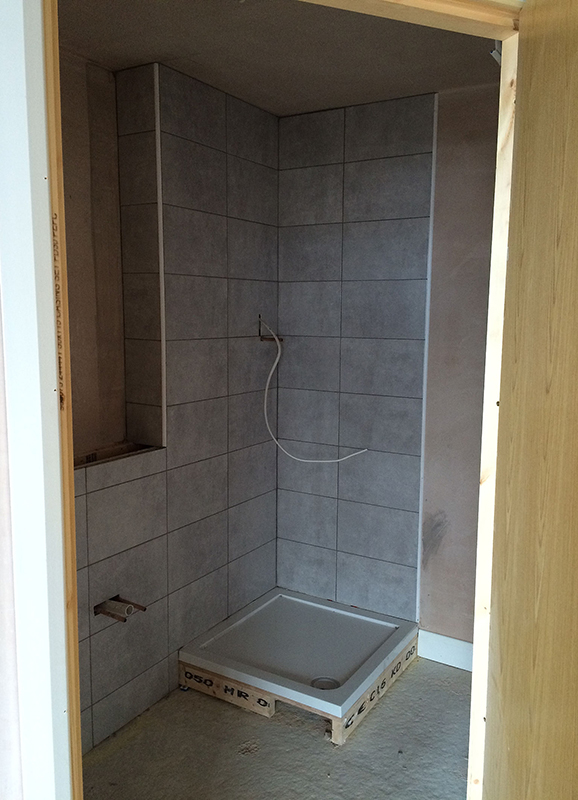

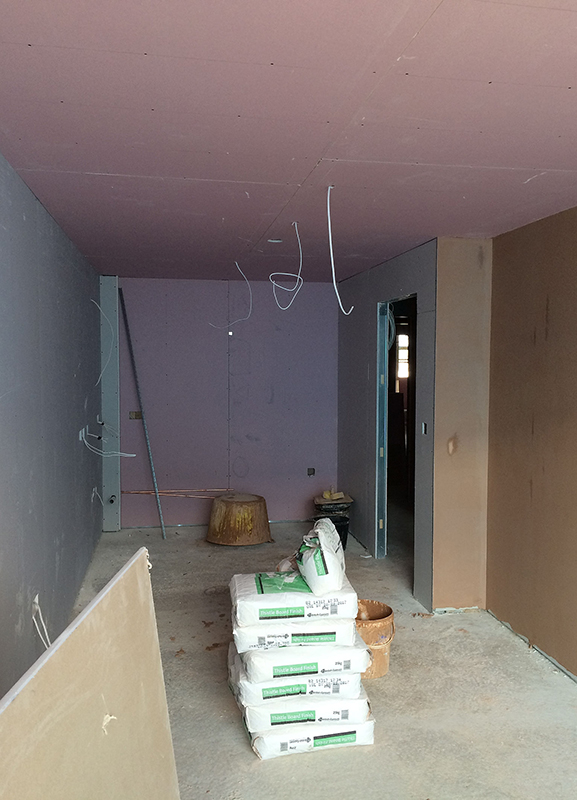

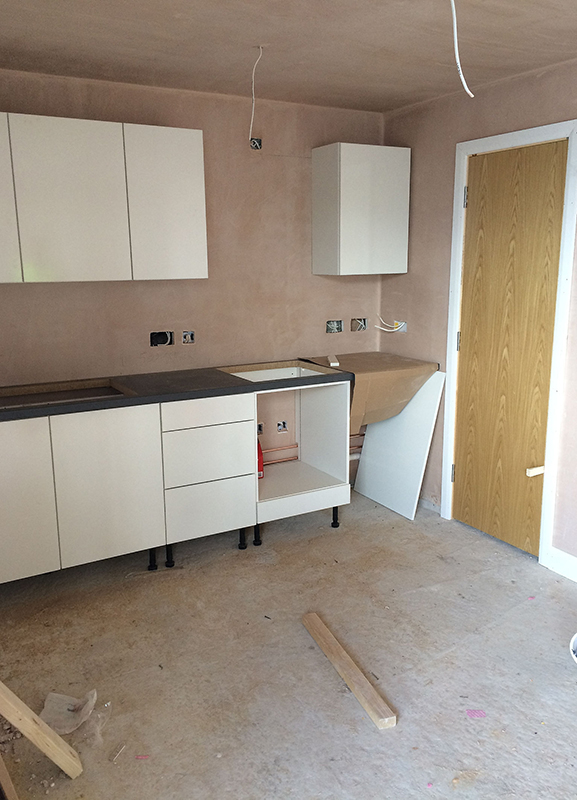

Victoria House | Development Progress 13/06/2017

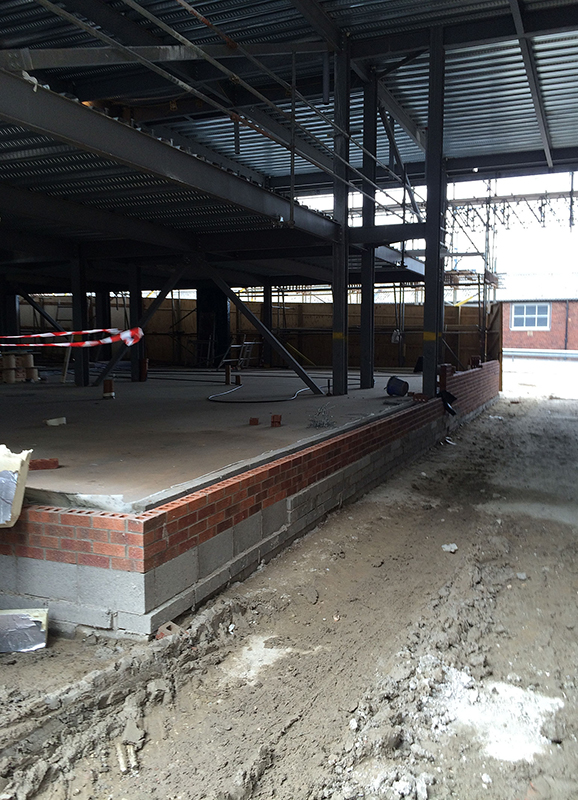

This recent update about the development progress of Victoria House in Leeds is dated from 13/06/2017. Trilandium noted that they experienced delays with the steelwork frame during the January and February period, which has delayed the works by approximately 4 weeks, therefore completion would now be approximately 6 November, 2017. However they have stated that they will endeavour to complete the works by 9 October 2017.
The attached report goes into more detail about what works have been completed and how things are progressing. Important points are below.
Main Points:
- Roof construction, 99% complete.
- External walls (brickwork) approx 99% complete.
- Internal walls (party walls), approx 75% complete.

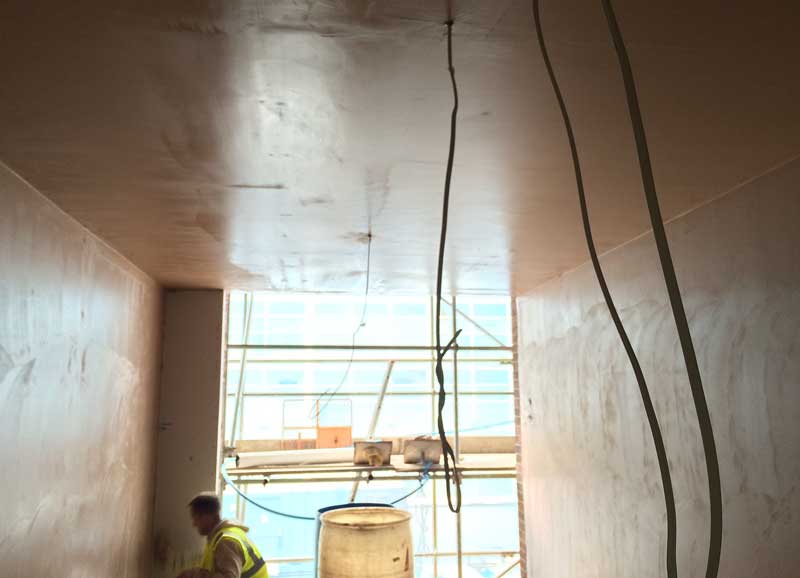

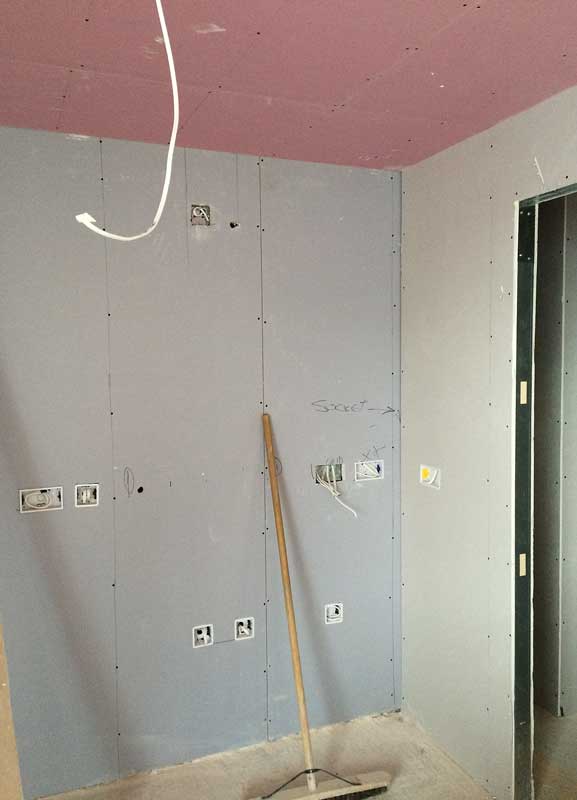

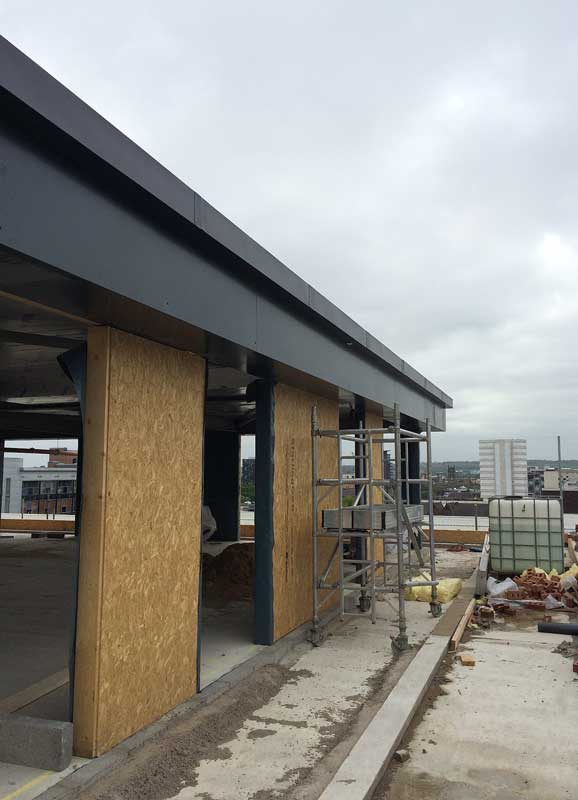

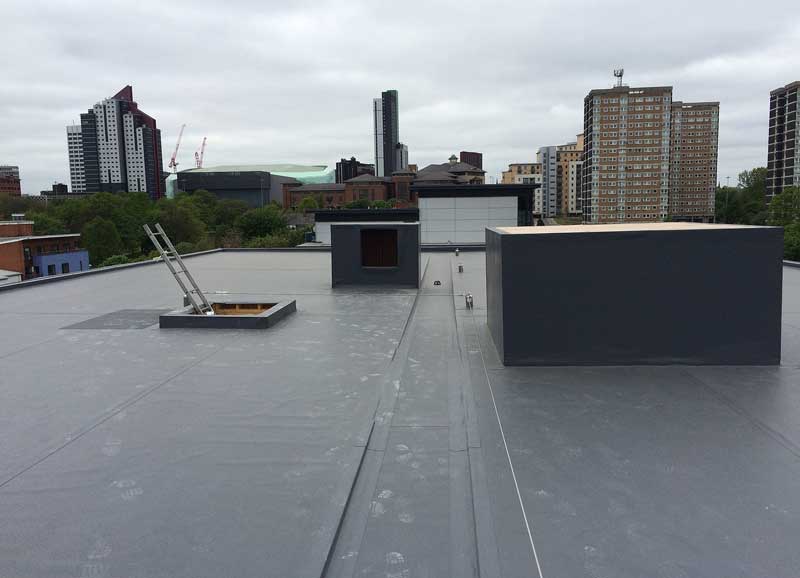

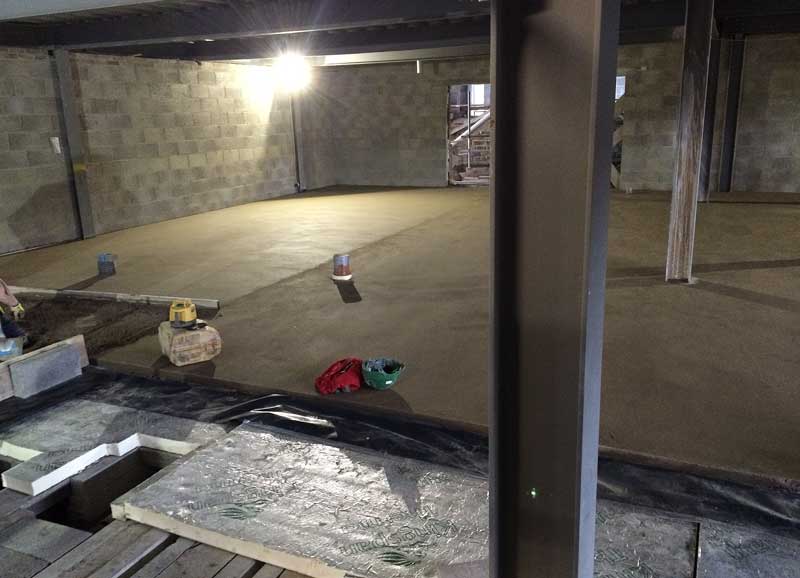

Victoria House | Development Progress 10/05/2017

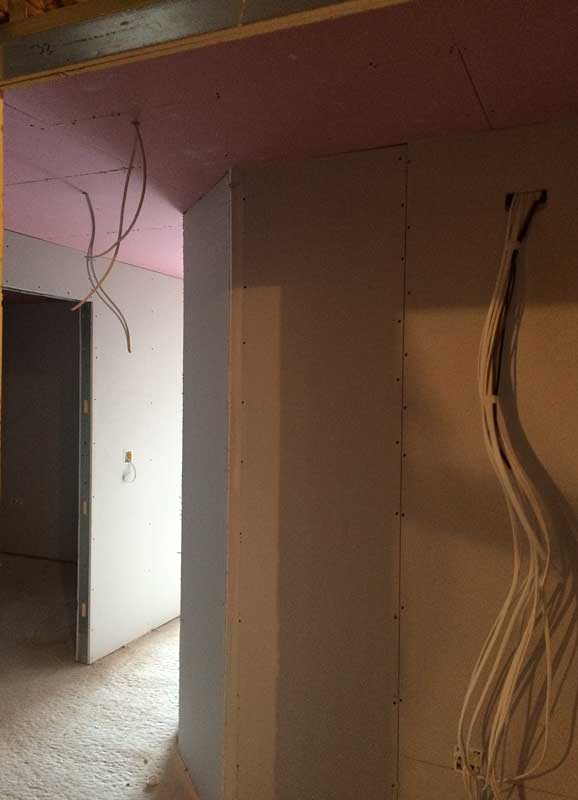

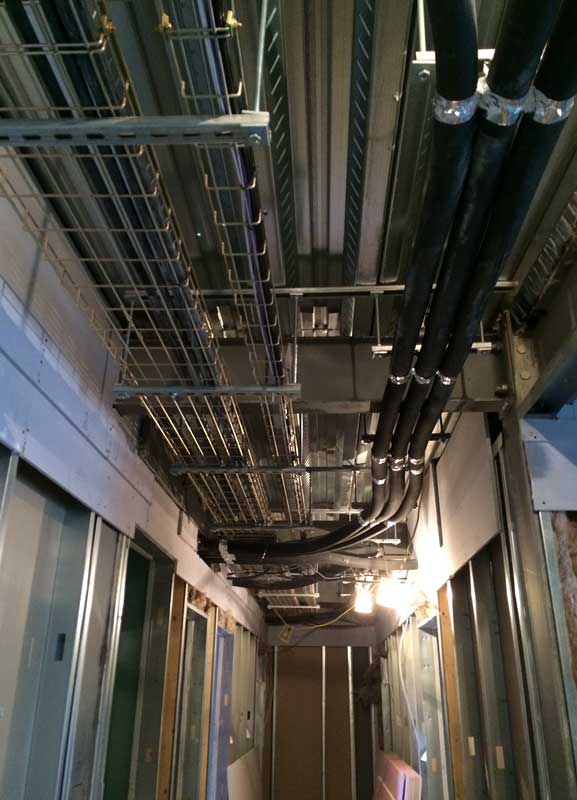

This recent update about the development progress of Victoria House in Leeds is dated from 10/05/2017. Following our last update, we are pleased to announce that several major aspects of the Victoria House project are now complete.
The attached report goes into more detail about what works have been completed and how things are progressing. Important points are below.
Main Points:
- Reduced level excavations, piling works, concrete ground beams and foundations, 100% complete.
- Steelwork frame erection (Main Building), metal decking, edge form work, concrete to upper floors, 100% complete.
- Pre-cast concrete staircase and lift shaft, 100% complete.

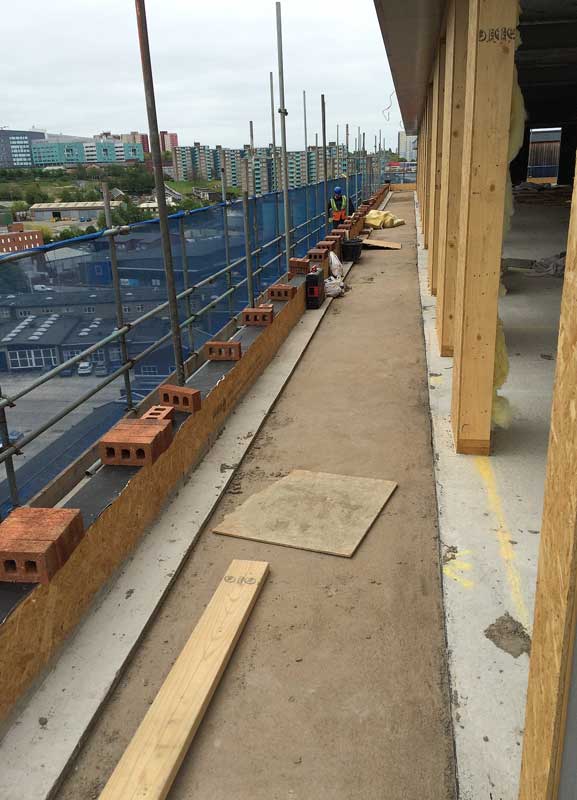

Victoria House | Development Progress 11/04/2017
This update about the development progress of Victoria House in Leeds is dated from 11/04/2017. We are pleased to announce that site scaffolding is now fully erected. This means the construction of the external wall can move quicker. The roof is also progressing well and is currently 50% complete.
The attached report goes into more detail about what works have been completed and how things are progressing. Important points are below.
Main Points:
- Block and Beam Ground Floor, approx 80% complete.
- Lift Shaft, 100% complete.
- External Wall construction approx 80% complete.
Victoria House | Development Progress 01/03/2017
This update about the development progress of Victoria House in Leeds is dated from 01/03/2017. We are happy to announce that the outstanding minor points in relation to the contract particulars have now been resolved,
The attached report goes into more detail about what works have been completed and how things are progressing. Important points are below.
Main Points:
- Reduced level excavations, piling works, concrete ground beams and foundations 100% complete.
- Steelwork frame erection, 100% complete (Main Building).
- Concrete to upper floors 100% completed.
Victoria House | Leeds
To invest in Victoria House or learn more about the development, please click the link below.
